Building Reliability: Electric Era's Multi-Layered Quality Approach
Written by
Mike Rudolf
on
May 6, 2025
At Electric Era, delivering reliable and high-performance EV charging solutions like our Nexus system isn't just a goal; it's embedded in our processes from the ground up. Reliability doesn't happen by accident. It's the result of meticulous planning, rigorous testing, and a commitment to quality at every stage – from the smallest component arriving at our facility to the final commissioning of a charging site.
Let's delve into the key processes that ensure the dependability our customers expect.

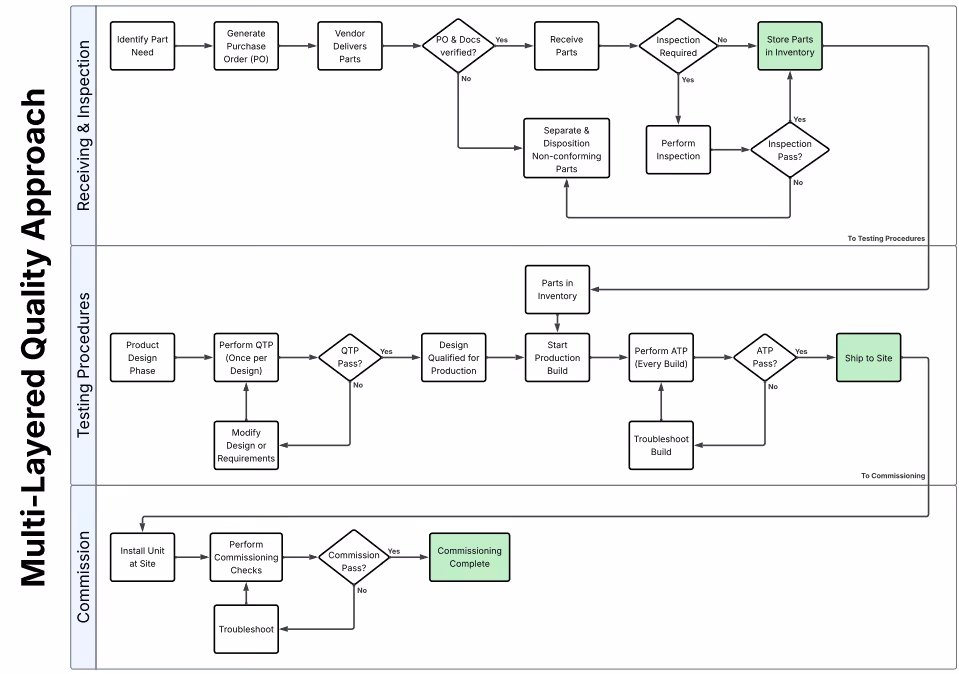

Starting Strong: Receiving & Inspection (R&I)
Quality begins before assembly even starts. Our R&I process ensures that every component entering our facility meets its requirements.
Procurement with Precision: We issue Purchase Orders (POs) tied to established quality contracts and detailed engineering drawings. This ensures clarity on requirements from the outset.
Verification at the Door: Our receiving team verifies deliveries against POs and checks for all required Quality Control (QC) documentation (like Certificates of Conformance or test data). Any discrepancy is immediately flagged.
Incoming Quality Inspection: For critical components, designated parts undergo thorough inspection. Our inspection validates key characteristics – dimensions, workmanship, material certifications – against engineering specifications. Parts only proceed if they meet every requirement. Non-conforming parts are separated and dispositioned.
Outcome: Only verified, conforming parts that meet our engineering and quality standards are accepted into inventory, forming a reliable foundation for our products.
Validating the Design and the Build: Qualification & Acceptance Testing (QTP & ATP)
Next we shift focus to validating the product design and ensuring each production unit is built correctly. This involves two distinct but complementary testing phases:
Qualification Test Procedure (QTP) - Proving the Design: Before moving into large scale production, the Nexus design undergoes rigorous QTP. This isn't a quick check; it's an exhaustive campaign to validate high risk design requirements.
Fault Injection: Intentionally creating faults to ensure safety systems react as designed.
Design Validation: Testing under various electrical grid conditions and harsh environmental temperatures (hot & cold).
Highly Accelerated Life Testing (HALT): Pushing the system to its limits to find potential weaknesses early.
Shipping Simulation: Ensuring the design can withstand the rigors of transport.
QTP is performed once per design, proving its inherent robustness.
We previously relied solely on vendors for component qualification, but are now actively building our in-house QTP capabilities for things such as HALT and environmental testing. This move complements vendor testing, allowing us to conduct thorough qualification on the entire system ourselves. This direct, system-level approach provides deeper root level understanding and enhances overall reliability.
Acceptance Test Procedure (ATP) - Verifying Every Unit: While QTP validates the design, ATP validates the build of every single Nexus unit before it leaves our facility. This shorter, focused test confirms correct assembly and core functionality:
Energizing the system and programming components.
Checking all internal communications.
Performing a full power charge/discharge cycle ("burn-in") to maximum and minimum state of charge (SOC).
Verifying essential functionality and efficiency metrics.
ATP ensures each unit shipped meets essential operational standards.
This entire ATP process is performed in-house; we currently possess all the required capabilities and specialized equipment needed to complete this comprehensive testing on every unit.
Outcome: QTP provides confidence in the fundamental design's reliability, while ATP confirms each individual unit functions correctly as intended off the production line.
Ensuring Site Readiness: Commissioning
Our commitment to quality extends beyond the factory floor to the installation site itself. Before any Electric Era charging station is opened to the public, it undergoes a final commissioning process.
Post-Installation Verification: After the physical setup is complete and the site is energized, technicians perform critical safety checks, ensuring that the equipment installation meets National Electrical Code (NEC) and internal standards.
System-Wide Checks: This includes verifying network communications back to monitoring systems, ensuring the battery charges fully (100% SOC), testing each individual charger port with a simulated load, and confirming every payment terminal processes transactions correctly.
Go/No-Go Decision: Only when all commissioning tests are successfully completed and documented, confirming the entire site operates safely and correctly, is the station opened for public access.
Outcome: Commissioning guarantees that the installed system functions seamlessly as a whole, providing a reliable charging experience for end-users from day one.
Conclusion: Quality as a Cornerstone
From inspecting incoming components (R&I) to validating the design (QTP), verifying each build (ATP), and confirming site operation (Commissioning), Electric Era employs a comprehensive, multi-layered approach to quality assurance. This rigorous dedication ensures that every Nexus system and charging station delivers the performance, safety, and unwavering reliability required for the demanding world of EV infrastructure. It's not just about building chargers; it's about building trust.
Stay tuned for future blog posts where we will dive deeper into the specifics of each of these crucial quality stages.
